Days 137 to 142 – week of 6 Jan 2020 – Qala

Days 137 to 142 – week of 6 Jan 2020 – Qala

by admin | 12 Jan 2020 | Bathrooms, Carpentry, Finishing Project, Kitchen, Light fittings, Tiling, Triq Il-Mithna, Qala

Days 137 to 142 – A fab week for changes in the apartment.  The main event was the delivery and installation of the kitchen (bought in Oct 2018) which looks amazing and totally goes with the floor tiles. Mon and Tue were consumed by fitting the parts of the...

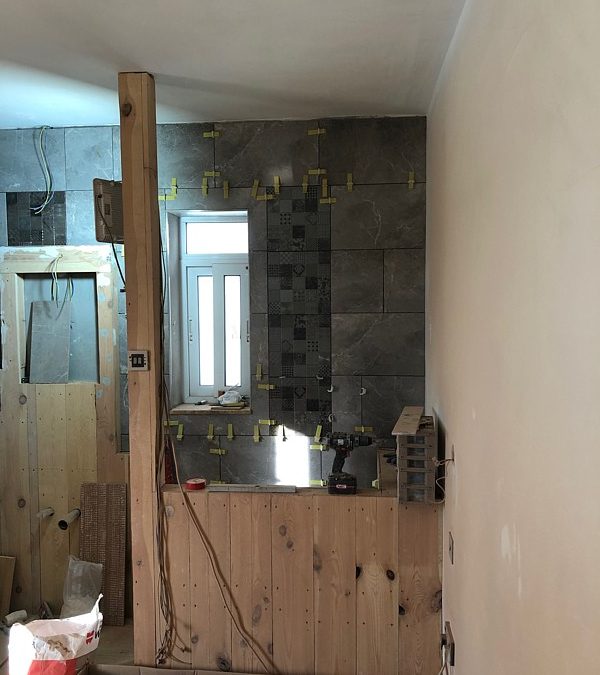

Days 132 to 136 – New Year week – Qala

Days 132 to 136 – New Year week – Qala

by admin | 5 Jan 2020 | Bathrooms, Finishing Project, Tiling, Triq Il-Mithna, Qala

Days 132 to 136 – Around 4 days worked in total with new year celebrations in the middle. A week of continued tiling and installing all waste pipes in the 3 toilet areas.  These were also weatherproofed when installed.  Once tiled, these 3 areas are ready to...
Days 128 to 131 – Christmas Week 2019 – Qala

Days 128 to 131 – Christmas Week 2019 – Qala

by admin | 29 Dec 2019 | Bathrooms, Carpentry, Finishing Project, Plastering, Tiling, Triq Il-Mithna, Qala

Days 128 to 131 – 3.5 days worked this week and a wonderful Christmas enjoyed with family and close friends! The focus on the finishing project has been on the en-suite in the master bedroom.  So, the stud wall for the shower cubicle is complete (together with...

Days 106 to 110 – Week of 18th Nov 19 – Qala

Days 106 to 110 – Week of 18th Nov 19 – Qala

by admin | 23 Nov 2019 | Bathrooms, Carpentry, Finishing Project, Tiling, Triq Il-Mithna, Qala

Days 106 to 110 – another busy week – no work Wednesday and half a day today but quite a bit done. The tiling of the rear balcony is complete bar for grouting (next week).  The tiling of the guest en-suite has continued and is looking great.  I’ve...
Days 102 to 105 – 11/12 & 14/15 Nov 19 – Qala

Days 102 to 105 – 11/12 & 14/15 Nov 19 – Qala

by admin | 16 Nov 2019 | Bathrooms, Finishing Project, Grouting, Tiling, Triq Il-Mithna, Qala

Days 102 to 105 – An interesting week with force 8/9 gales and no windows!  Only 4 days worked due to me walking on Wednesday and a guest. However, a busy week.  Last weekend we visited the window builder and saw the windows and rear balcony railing.  The...
« Older Entries
Next Entries »

Recent Posts

  • German Cottage Refurbishment – 12 Jul to 9th Sep 2021
  • Days Lots! Weeks of 9th and 16th Mar 2020 – Qala, the final post
  • Days 179 to 183 – week of 2nd March 2020 – Qala
  • Days 174 to 178 – week of 24th Feb 2020 – Qala
  • Days 165 to 173 – weeks of 10 & 17 Feb 2020 – Qala

Categories

  • Air Con
  • Bathrooms
  • Carpentry
  • Chimney
  • Circuit Breakers
  • Doorways
  • Finishing Project
  • Fireplace
  • Floor
  • Floor screed
  • German Cottage Refurbishment
  • Grouting
  • Insulation
  • Kitchen
  • Light fittings
  • Membrane
  • Pallet to Wine Rack
  • Plastering
  • Plumbing
  • Render
  • Roof
  • Skylight
  • Sockets
  • Terrace
  • Tiling
  • Triq Il-Mithna, Qala
  • Underfloor Heating
  • Window Sills
  • Windows
  • Wiring
Copyright © 2024 Kluvi - all rights reserved.
