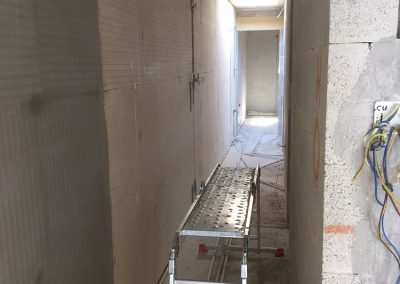

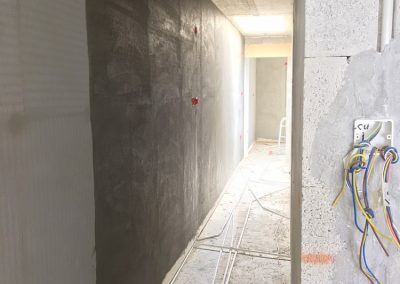

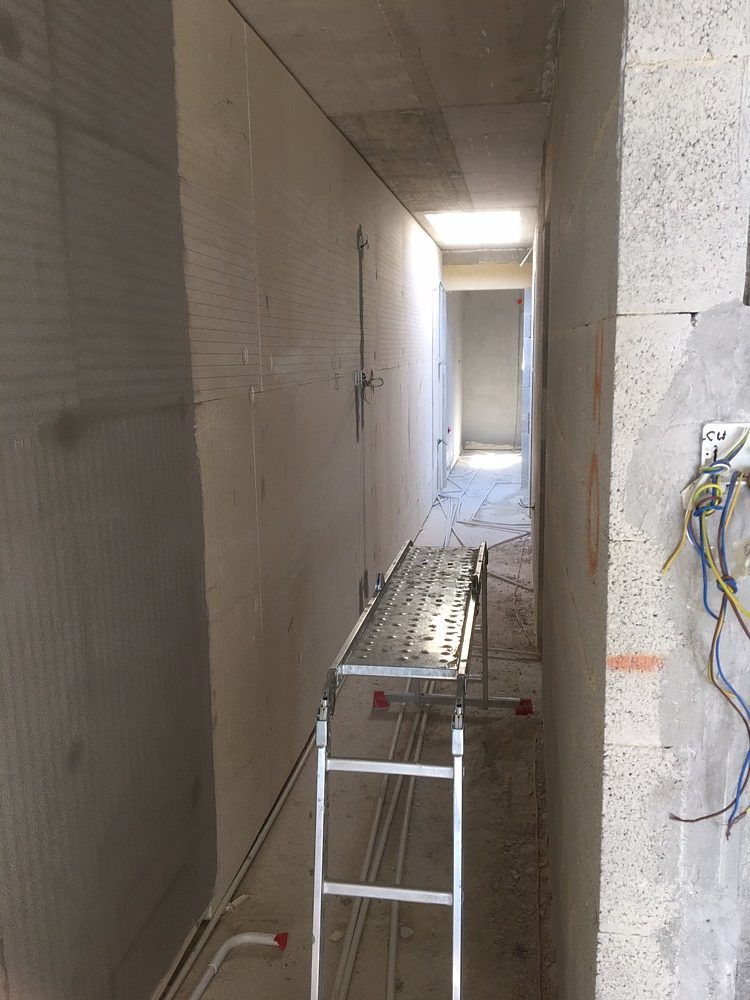

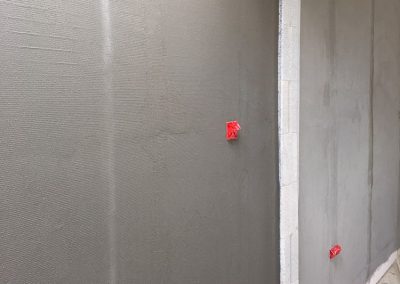

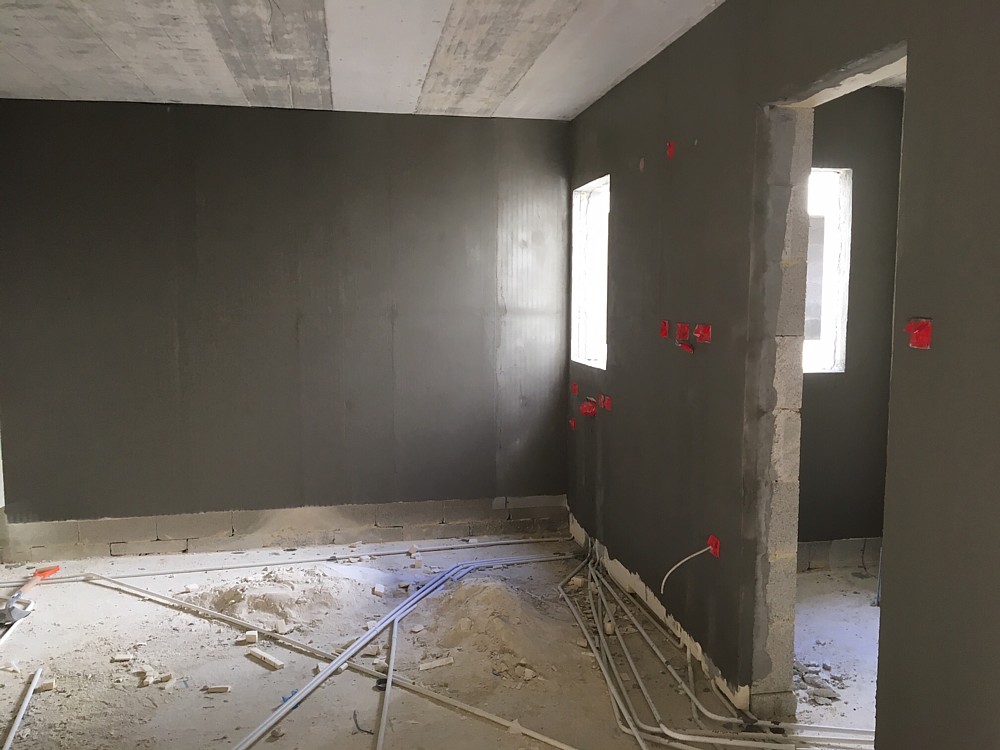

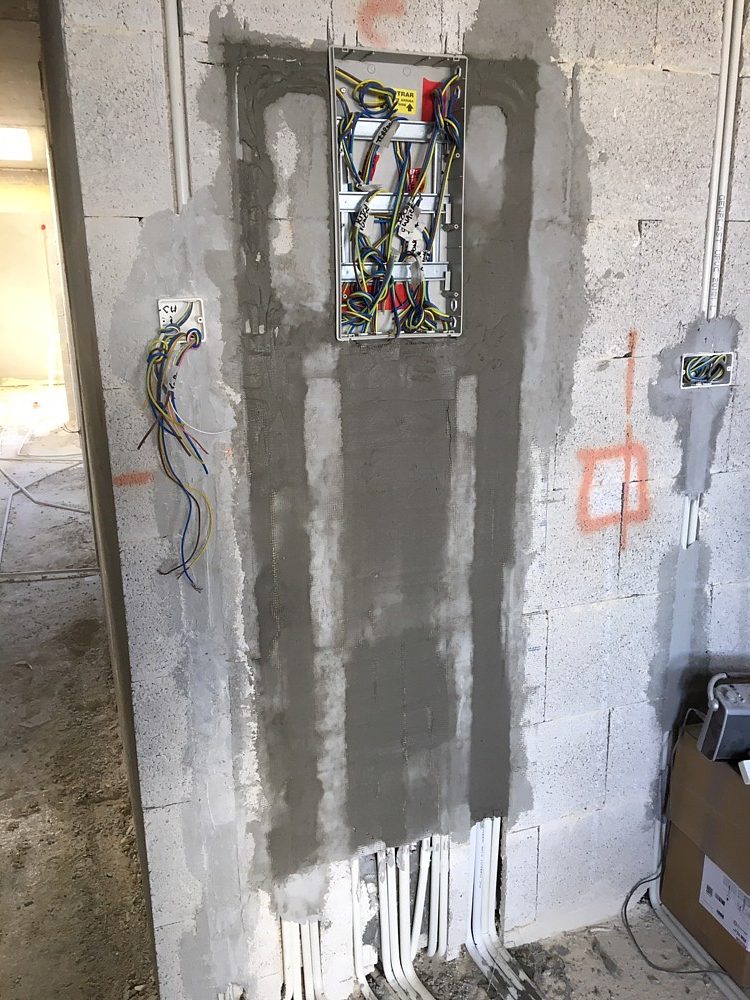

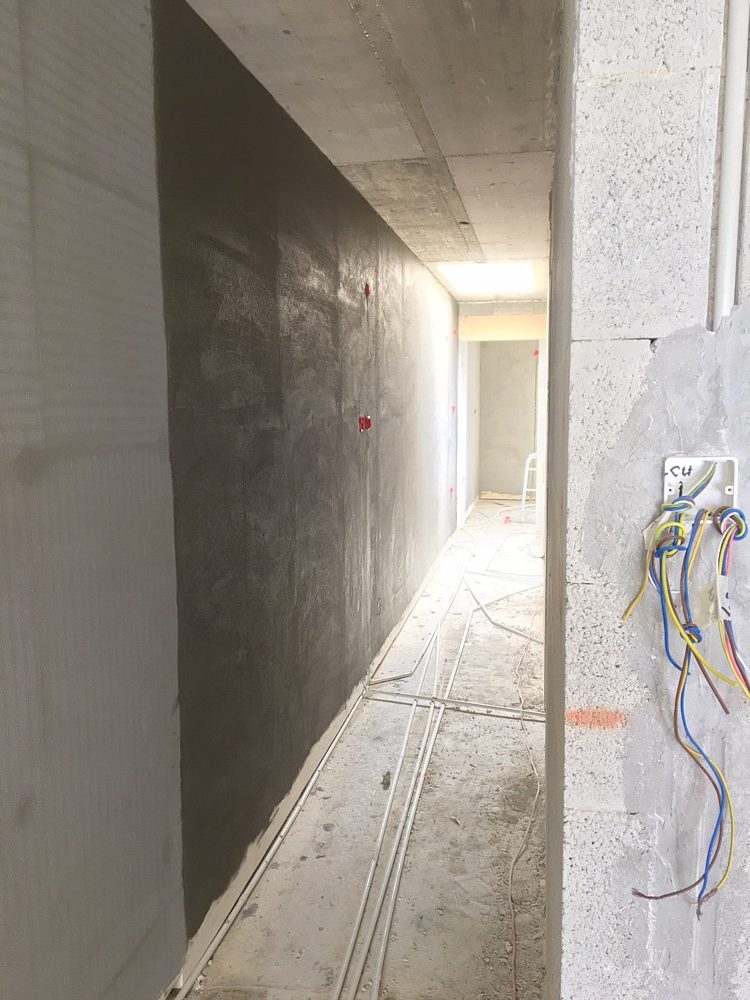

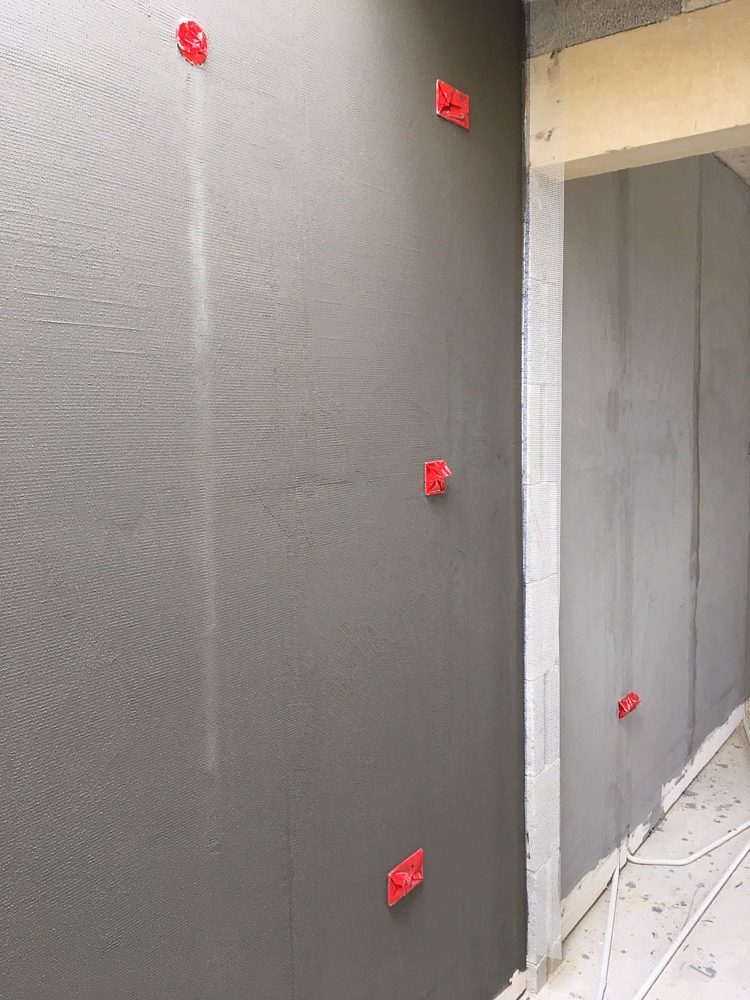

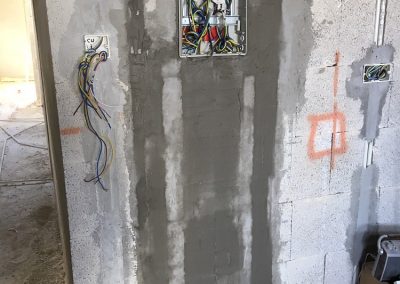

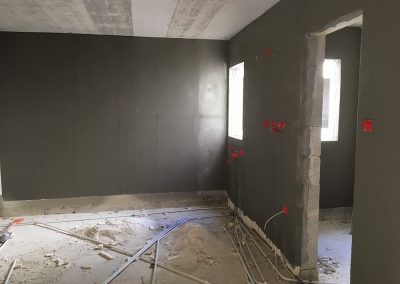

Days 30 & 31 – Fibreglass mesh and rendering is complete over all insulation so yesterday and today I completed the master bedroom, guest bedroom & en-suite, main bathroom and hallway.  I also started filling over the conduit going to the consumer unit and also the 7 conduits going to the heatmiser from the thermostats.

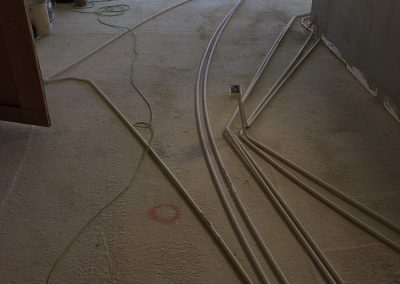

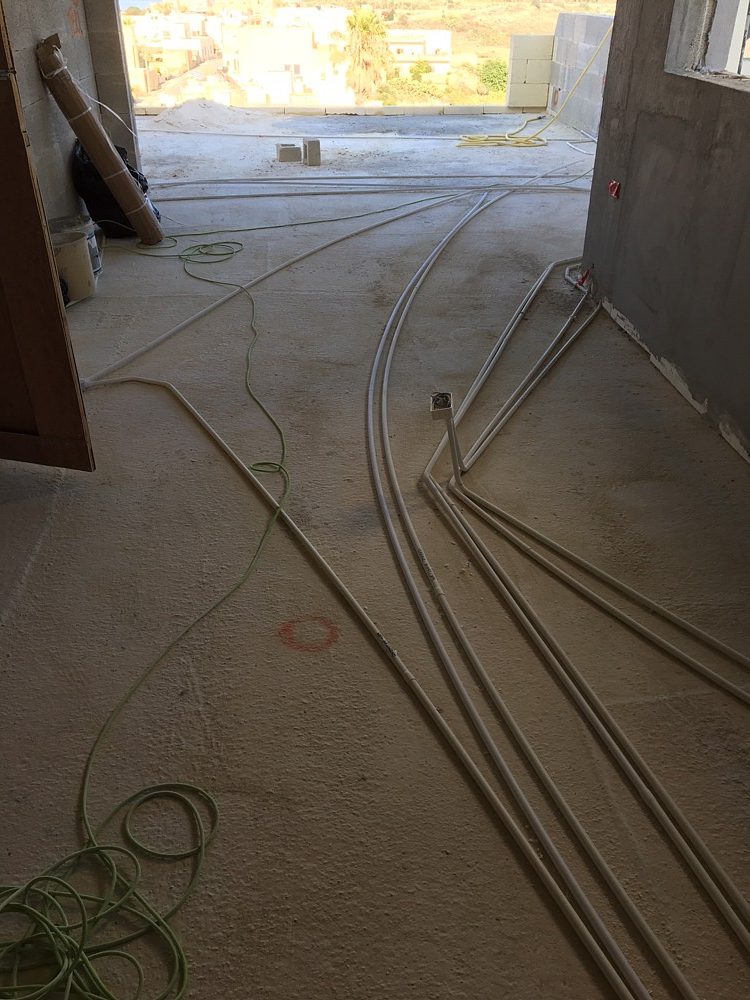

Next week I’ll crack on with the floor for which I’ve already spent a couple of hours on hands and knees knocking away the lumps of spilt concrete left by the builder.

The only disappointment was the no-show by the plasterer (shouldn’t be surprised really).
